Fangda Weighing Instruments (Fujian, China) – A Professional Manufacturer of Weighbridges & Truck Scale.

Concrete vs Steel Weighbridge: Which One Is Better for Mining and Logistics?

2026-06-11 10:27 Fujian Fangda Weighbridge Manufacturer

Youre buying a weighbridge for a mine, a port, or a busy logistics yard. One supplier says steel is cheaper and faster. Another says concrete is stronger and lasts longer. Whos right?

At Fujian Fangda Weighbridge & Truck Scale Manufacturer, weve installed and serviced both types across Africa and Asia. Heres what real field data from the past 10 years tells us. No marketing fluff just what actually works.

image-Fangda-Weighbridge

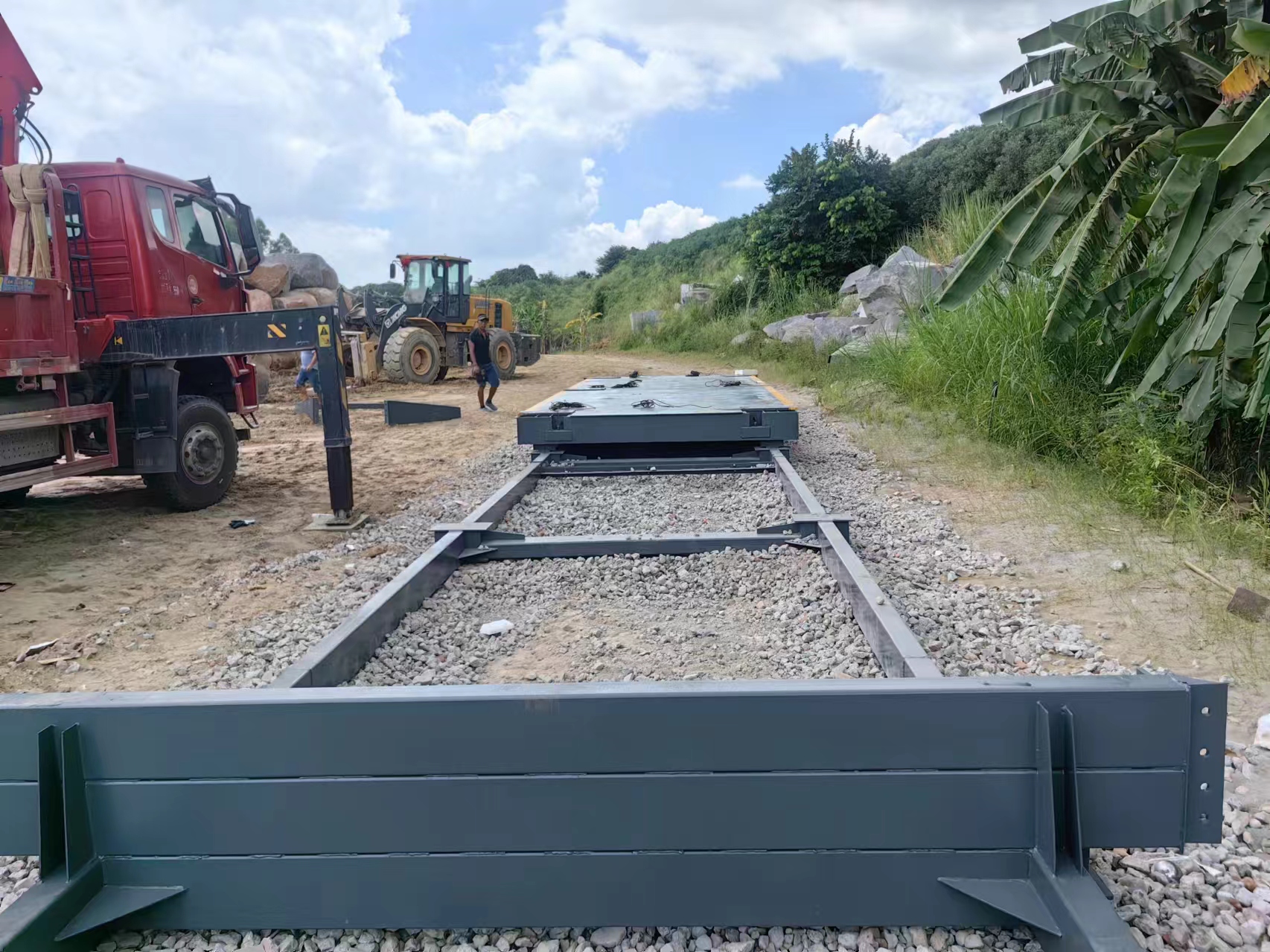

Steel weighbridge the fast, flexible choice

How its built: Prefabricated steel modules bolted together on site. No concrete pouring except for foundations.

Real advantages:

- Faster installation: A 3person crew can assemble a steel scale in 23 days. Concrete takes 23 weeks (plus curing).

- Lower shipping cost: One 20ft container holds most 6080 ton steel scales. Concrete requires separate steel frame shipping plus local concrete.

- Relocatable: Need to move the scale after 3 years? Unbolt it, load on a truck, go.

- Better for poor local concrete quality: If you dont trust local construction, a steel scale with proper foundations is more predictable.

Where it struggles (data from our service logs):

- Overload: A steel scale run at 120% of rated capacity every day shows visible deck sag in 45 years. Reinforced steel (12mm deck, tight beam spacing) lasts longer 810 years but still less than concrete under extreme abuse.

- Corrosion: In coastal areas (Mombasa, Dar es Salaam), standard painted steel rusts through in 34 years. Hotdip galvanizing extends to 1012 years but adds 1520% to cost.

- Vibration: Steel transmits more vibration from heavy trucks, which can affect sensor stability. One Zambian mine switched from steel to concrete and saw drift drop by 0.15% on average.

Best for: Logistics yards, farms, construction sites, mediumtraffic transport hubs, or any site where speed and flexibility matter more than 20year life.

image-Fangda-Weighbridge

Concrete weighbridge the heavyduty survivor

How its built: Steel reinforcement frame + concrete poured locally on prepared foundations.

Real advantages:

- Durability under overload: A properly built concrete scale handles 150% of rated load with no structural bending. In a DRC copper mine running 100ton trucks on an 80ton concrete scale, we saw no deck deformation after 8 years.

- Stability in heat: Concrete expands and contracts less than steel. In 45°C ambient with 65°C ground temperature, steel deck can expand 810mm, affecting alignment. Concrete moves about half that.

- Vibration damping: Concrete absorbs shock from heavy axles. Load cells on a concrete scale typically last 12 years longer than identical cells on a steel scale in the same mine.

- Low longterm maintenance: No repainting every 35 years. No bolt tightening. One concrete scale in a Tanzanian cement plant required only minor load cell replacements in 14 years.

Where it struggles:

- Longer installation: Foundation prep + rebar + pouring + curing = 34 weeks minimum. Add another week for the steel framework.

- Higher upfront cost: Concrete scale typically costs 2030% more than an equivalent steel scale (including civil work).

- Not movable: Once poured, its permanent.

- Requires good local concrete work: Poor mix or bad rebar placement leads to cracks. Weve seen concrete scales fail in 5 years because of bad local construction not the scales fault.

Best for: Mines, quarries, ports, cement factories, heavy industrial sites with 24/7 traffic and no plans to relocate.

One real example: Two mines in Zambias Copperbelt identical truck loads, similar climate. Mine A bought a reinforced steel scale (galvanized). Mine B bought a concrete scale. After 10 years: Mine A had repainted once, replaced two load cells, and had minor deck sag. Still working, but showing age. Mine B had replaced three load cells, no structural issues, still accurate. Both were good choices but the concrete scale had lower longterm hassle.

---

So which one should you buy?

Ask yourself these three questions:

1. Is this a permanent site or might you move the scale in 5 years?

  - Permanent concrete. Might move steel.

2. Do you regularly overload your trucks by 20% or more?

  - Yes concrete. No steel is fine.

3. Is local concrete construction quality reliable?

  - Yes concrete is great. No steel avoids that risk.

Our default advice:

- For mines, ports, heavy industry concrete, unless you have a strong reason to choose steel.

- For logistics parks, farms, construction sites, medium traffic steel, with galvanizing if near coast.

- For temporary or rental operations steel only.

---

What Fujian Fangda Weighbridge & Truck Scale Manufacturer delivers for both

We manufacture both steel and concrete weighbridge systems. For steel, we use 12mm deck, Ubeam spacing 300mm, IP68 stainless cells, and offer hotdip galvanizing. For concrete, we provide detailed rebar and formwork drawings, remote installation support, and the same highquality load cells and indicators.

Whichever you choose, we help you match the structure to your real working conditions not just the lowest price.

---

Bottom line

Steel is faster and more flexible. Concrete is tougher and longerlasting. Neither is better” – it depends on your site, your trucks, and your longterm plan.

Need help deciding? Send us your daily truck count, typical overload, and site photos. Well tell you which one has worked best for similar operations weve done. No sales pressure just real advice.

Fujian Fangda Weighbridge & Truck Scale Manufacturer weighbridges built for the way you actually work.

---
